BBMP Building Plan Approval Process Bangalore 2026 Guide

Navigating Bangalore's building plan approval process with the BBMP requires careful preparation and understanding of complex documentation requirements across four municipal zones. This 2024 guide breaks down every essential step, from gathering critical documents like architectural plans and environmental clearances to navigating digital submission systems and timeline expectations. Whether you're developing residential, commercial, or industrial projects, mastering the BBMP approval process is key to avoiding costly delays and ensuring compliance with updated regulations.
BBMP Building Plan Approval Process Bangalore 2026 Guide


Building Plan Approval Process in Bangalore: A Complete Guide for 2024

Bangalore's rapid urbanization has made it one of India's most dynamic real estate markets. However, navigating the building plan approval process with the Bruhat Bengaluru Mahanagara Palike (BBMP) can be complex and time-consuming. Whether you're planning a residential project, commercial space, or industrial facility, understanding the approval process is crucial to avoid delays and penalties.

This comprehensive guide walks you through every step of the BBMP building plan approval process, timelines, costs, and recent changes that affect project planning in Bangalore.

Cost estimator

Build cost · Bengaluru, May 2026

Estimated turnkey cost
₹79.67 L
₹74.09 L₹87.63 L₹4,426/sqft
Civil Services Finishes Fees Inclusions
Excludes land, GST & statutory fees. ±10% based on site conditions.Get 3 matched quotes

Understanding BBMP and Its Role in Building Approvals

The Bruhat Bengaluru Mahanagara Palike (BBMP) is Bangalore's municipal corporation responsible for issuing building permits and approvals. As the city's population has grown to over 12 million, the BBMP has implemented digital systems to streamline the approval process.

The BBMP's jurisdiction covers the entire Bangalore Metropolitan Area, divided into four zones:

East Zone – covering areas like Whitefield, Marathahalli, and Bellandur

West Zone – including Rajajinagar, Yeshwanthpur, and Peenya

South Zone – covering Banashankari, Jayanagar, and Koramangala

North Zone – including Hebbal, Yelahanka, and Ramamurthy Nagar

Key Documents Required for Building Plan Approval

Essential Documentation

Before submitting your application to BBMP, ensure you have the following documents prepared:

Title Deed and Property Papers – Original ownership documents or registered sale deed

Site Plan – Scaled drawing showing property boundaries and dimensions (typically 1:500 scale)

Architectural Plans – Detailed floor plans, elevations, and sections prepared by a registered architect

Structural Drawings – Designed by a structural engineer as per Indian Standards (IS codes)

MEP Plans – Mechanical, Electrical, and Plumbing designs

Environmental Clearance – If applicable, based on project size and type

Layout Approval – For layouts from revenue department (if applicable)

NOC from Fire Department – For commercial and multi-story residential buildings

Soil Test Report – Geotechnical investigation report

Parking Plan – Detailed parking layout as per BBMP norms

Affidavit and Indemnity Bond – Self-attested declaration forms

The cost of preparing these documents typically ranges from ₹15,000 to ₹50,000 depending on project size and complexity.

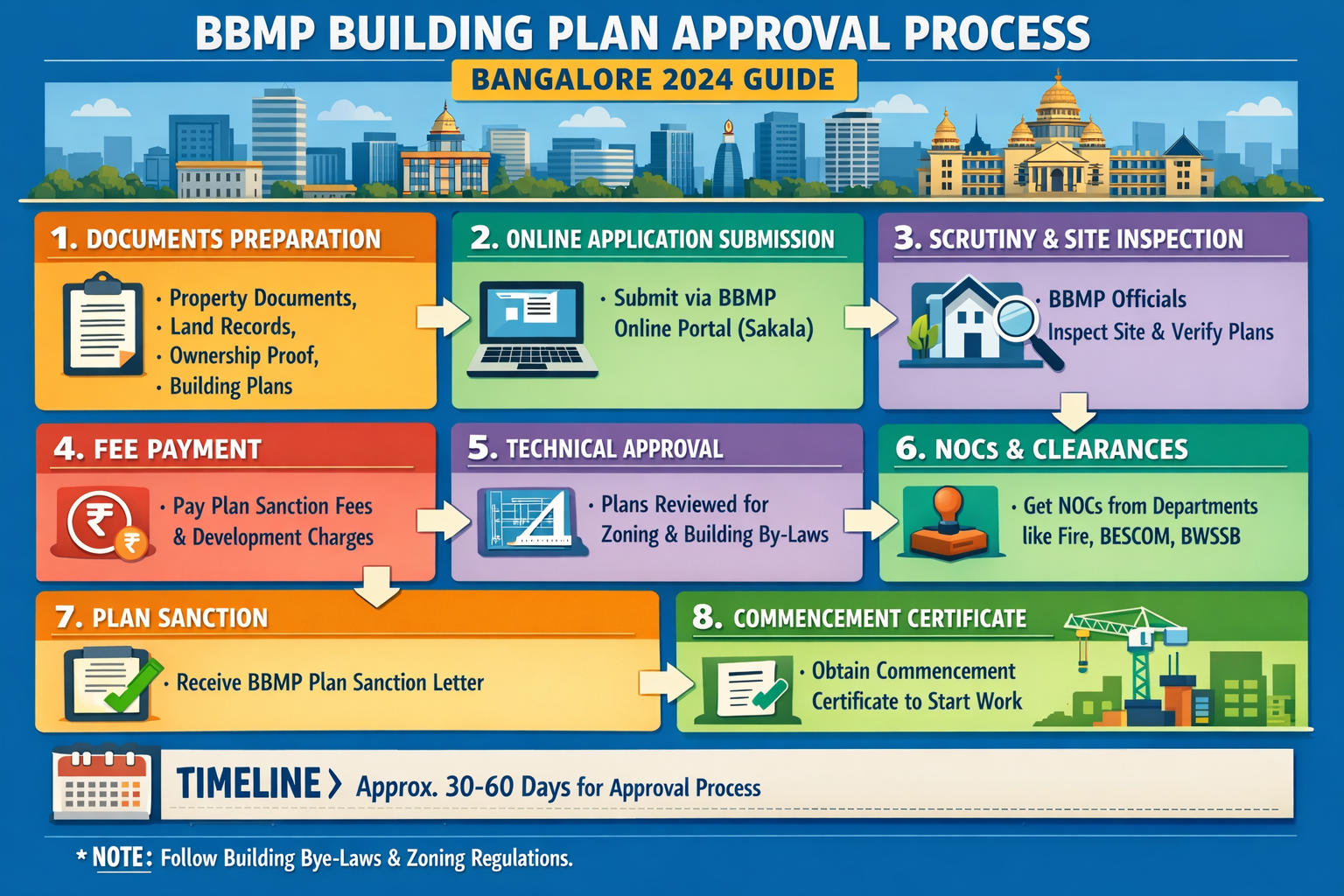

The BBMP Building Plan Approval Process: Step-by-Step

Step 1: Pre-Submission Consultation

Before formal submission, it's advisable to have a pre-submission meeting with the BBMP officials. This informal consultation helps identify potential issues early and clarifies specific requirements for your project type.

You can book an appointment through the BBMP online portal or visit your respective zone office. Many architects recommend this step as it can save weeks of back-and-forth correspondence later.

Step 2: Online Application Submission

BBMP has digitized the approval process through its online portal. The steps include:

Register on the BBMP e-Governance portal (bbmp.gov.in)

Create a project profile with property details

Upload all required documents in PDF format (maximum 25 MB per file)

Pay the application fee (non-refundable)

Generate the application reference number

Application Fees (as of 2024):

Residential buildings (up to 1,000 sq.m): ₹5,000 to ₹10,000

Residential buildings (1,000 to 5,000 sq.m): ₹15,000 to ₹25,000

Commercial buildings: ₹20,000 to ₹50,000

Industrial structures: ₹25,000 to ₹60,000

Step 3: Initial Scrutiny by BBMP

Once submitted, the BBMP conducts an initial document review, typically completed within 5-7 working days. During this phase, they verify:

Completeness of documentation

Compliance with zoning regulations

Adherence to setback requirements

Floor Area Ratio (FAR) compliance

Ground coverage limits

If documents are incomplete, the BBMP issues a deficiency notice. You'll have 15 days to submit missing documents or clarifications.

Step 4: Detailed Technical Examination

After initial scrutiny passes, the plan goes to the technical examination team. This is the most critical phase where detailed checks occur:

Site Verification – BBMP officials visit the site to verify ground conditions

Building Code Compliance – Checking against National Building Code (NBC) 2016

Safety Standards – Fire safety, electrical safety, structural safety

Environmental Norms – Stormwater management, waste management plans

Accessibility Standards – Compliance with PWD norms

This phase typically takes 20-30 days. The BBMP may raise queries (called "Observations") requiring clarification or design modifications.

Step 5: Response to Observations

If the BBMP raises observations, you have 15 days to respond with clarifications or revised drawings. Common observations include:

Inadequate parking provision

Setback violations

FAR exceedance

Insufficient green space

Fire exit issues

Multiple rounds of queries can extend the timeline. On average, 2-3 rounds of observations are common for complex projects.

Step 6: Approval and Issuance of Permission

Once all observations are satisfactorily addressed, the BBMP issues the Building Plan Approval Certificate and Occupancy Certificate (OC) eligibility letter. This approval is valid for 3 years from the date of issue. If construction hasn't commenced within this period, renewal is required.

You also receive:

Building Permission Number

Approved plan set (stamped)

Conditions to be followed during construction

Timeline for commencement and completion

Timeline and Processing Duration

The total time from application submission to approval varies based on project complexity:

Simple Residential (single/double story) – 45-60 days

Multi-story Residential (5-10 floors) – 60-90 days

Commercial Buildings – 75-120 days

Complex Projects (with environmental clearance) – 120-180 days

These timelines assume complete documentation and minimal observations. Delays occur when:

Documents are incomplete or unclear

Multiple rounds of observations are raised

Site verification reveals discrepancies

Environmental or heritage clearances are required

Neighboring property disputes exist

BBMP Building Regulations and Compliance Requirements

Floor Area Ratio (FAR) Norms

FAR determines how much built-up area is permitted on a given plot size. Bangalore's FAR varies by zone:

Residential areas – FAR of 2.0 to 3.0 (depending on location)

Commercial zones – FAR of 4.0 to 6.0

Industrial areas – FAR of 1.5 to 2.5

Mixed-use zones – FAR of 3.0 to 4.0

For example, a 1,000 sq.m residential plot in a 2.0 FAR zone can have a maximum built-up area of 2,000 sq.m.

Setback Requirements

Setbacks are mandatory open spaces from property boundaries:

Front setback – 4.5 meters (6 meters in some zones)

Side setbacks – 2 meters each side

Rear setback – 3 meters

Corner plots have additional requirements. These setbacks ensure adequate ventilation, light, and emergency access.

Ground Coverage

Ground coverage (the percentage of plot covered by the building footprint) is typically limited to 50-60% for residential areas and 70-80% for commercial zones.

Parking Norms

BBMP mandates parking based on building type and size:

Residential – 1 space per 100 sq.m of built-up area (minimum 1 per unit)

Commercial – 1 space per 100 sq.m

Office – 1 space per 250 sq.m

Retail – 1 space per 50 sq.m

Parking can be provided on-site, in basements, or through registered parking agreements with nearby facilities.

Recent Changes and Updates in BBMP Approval Process (2024)

Digital Transformation Initiatives

The BBMP has significantly improved its digital infrastructure:

Complete Online Processing – All submissions and approvals now happen digitally, reducing in-person visits

Real-time Tracking – Applicants can track their application status 24/7 through the portal

Automated Deficiency Notices – System automatically identifies missing documents and notifies applicants

e-Payment Gateway – Secure online payment for all fees and charges

Fast-Track Approval Scheme

BBMP introduced a fast-track option for certain project categories:

Eligible Projects – Small residential buildings (up to 2,000 sq.m), simple structures

Additional Fee – 25% premium on standard approval fees

Timeline – Approval within 30 days (guaranteed)

Process – Streamlined examination without multiple observation rounds

The fast-track scheme costs approximately ₹2,500 to ₹7,500 additional but saves significant time for straightforward projects.

Green Building Incentives

Projects meeting green building standards (IGBC, LEED) receive:

FAR relaxation up to 10%

Parking norm relaxation

Expedited approval (15% faster processing)

Property tax concessions (up to 20% for 5 years)

Common Reasons for Plan Rejection or Delays

Technical Non-Compliance

Violation of setback norms

FAR exceedance

Inadequate fire exits and emergency provisions

Insufficient parking provision

Structural design not conforming to IS codes

Documentation Issues

Unclear or incomplete architectural drawings

Missing structural calculations

Unsigned documents or missing professional seals

Outdated title deeds or property documents

Encroachments on neighboring properties

Disputes over property boundaries

Unauthorized structures on site

Inadequate road frontage

Environmental and Heritage Concerns

Proximity to water bodies or wetlands

Location in heritage zones

Inadequate stormwater management plans

Environmental impact assessment requirements

Cost Breakdown for Building Plan Approval in Bangalore

Here's a realistic cost estimate for obtaining building plan approval for a typical residential project in Bangalore:

Item

Cost Range (INR)

Architectural Design & Planning

₹15,000 – ₹40,000

Structural Engineering & Drawings

₹20,000 – ₹50,000

MEP Design (Electrical, Plumbing, HVAC)

₹10,000 – ₹30,000

Soil Investigation & Testing

₹8,000 – ₹15,000

BBMP Application Fee

₹5,000 – ₹25,000

Consultant/Agent Fees (if hired)

₹10,000 – ₹30,000

Fire Department NOC

₹2,000 – ₹5,000

Miscellaneous (copies, stamps, etc.)

₹3,000 – ₹8,000

Total Estimated Cost

₹73,000 – ₹2,03,000

For larger commercial or complex projects, costs can exceed ₹5,00,000 depending on project specifications.

Tips for Smooth Building Plan Approval

Pre-Submission Best Practices

Engage Qualified Professionals – Hire BBMP-registered architects and structural engineers familiar with current regulations

Verify Property Documents – Ensure clear title with no disputes or encumbrances

Conduct Site Survey – Get accurate measurements and identify ground conditions early

Review Zoning Rules – Check the specific zone regulations for your property location

Prepare Comprehensive Plans – Include all details to avoid deficiency notices

During Processing

Maintain Regular Communication – Follow up with BBMP officials to understand observations promptly

Respond Quickly to Queries – Submit responses within the stipulated 15-day period

Provide Clear Clarifications – Use diagrams and detailed explanations for technical observations

Document Everything – Keep copies of all submissions and correspondence

Leverage Technology

Many professionals now use AECORD's B2B2C marketplace to connect with verified architects, structural engineers, and BBMP compliance consultants in Bangalore. The platform provides:

Pre-vetted professionals with BBMP experience

Real-time project tracking and collaboration

Document management tools

Cost comparison for different service providers

Post-Approval: Next Steps

Obtaining Occupancy Certificate (OC)

After construction completion, you must apply for an Occupancy Certificate. The process includes:

Completion of all structural work as per approved plans

Installation of safety systems (fire, electrical, plumbing)

Third-party inspection and compliance certification

BBMP final inspection

Issuance of OC (typically within 30-45 days of application)

Property Registration

Once OC is obtained, register the property with the Sub-Registrar's office. This is mandatory for legal ownership transfer and obtaining property tax assessments.

Frequently Asked Questions

How long is a BBMP building approval valid?

A BBMP building plan approval is valid for 3 years from the date of issue. If you haven't commenced construction within this period, you must apply for renewal. The renewal process is simpler and faster than the initial approval, typically taking 15-20 days.

Can I make changes to approved plans after receiving approval?

Minor changes (up to 10% modification in built-up area or layout) can be accommodated through a "Plan Modification" application, which costs approximately 50% of the original approval fee and takes 15-20 days. Major changes require resubmission of the entire application.

What happens if I build without approval or violate approved plans?

Unauthorized construction can result in demolition orders, heavy fines (up to ₹2,00,000), and criminal prosecution. The BBMP has increased enforcement, with regular surveys and drone monitoring in Bangalore. Always obtain proper approval before construction.

Is environmental clearance required for all projects in Bangalore?

Environmental clearance is required for projects exceeding 20,000 sq.m built-up area or specific sensitive locations (near water bodies, forests, heritage areas). Smaller projects need only environmental compliance certification from a BBMP-recognized consultant, which costs ₹5,000-₹10,000.

Can I hire a consultant to manage the BBMP approval process?

Yes, many BBMP-registered consultants specialize in plan approvals and can handle the entire process on your behalf. They typically charge ₹15,000-₹50,000 depending on project complexity. While it adds cost, it saves time and reduces rejection risks, especially for first-time builders.

Conclusion

The BBMP building plan approval process in Bangalore has become significantly more streamlined with digital transformation, but it still requires careful attention to regulations, proper documentation, and professional guidance. Understanding the steps, timelines, and requirements outlined in this guide will help you navigate the process more efficiently.

Whether you're a homeowner planning a residential extension or a developer undertaking a large commercial project, investing in qualified professionals and thorough planning upfront can save considerable time and money. With Bangalore's continued growth, staying compliant with BBMP regulations is not just a legal requirement—it's essential for the long-term value and marketability of your property.

Start your project with clear documentation, engage experienced professionals, and maintain regular communication with BBMP authorities for a smoother approval journey.


AECORD Editorial Team
Written by
AECORD Editorial Team
AECORD Verified ExpertReviewed by 2 editorsLast updated 3 Apr 2026
Share

Discussion

Loading comments...
Newsletter

One thoughtful email on what the world is building.

Cost benchmarks, the week’s standout projects, and our editor’s notes — curated for the global AEC community. No spam, no resellers — unsubscribe in one click.

Weekly editor’s pick
The single article our editors think is worth your time, every Sunday.
Cost benchmark refresh
New per-sqft data from our verified site BOQs, delivered as it lands.
Reader project of the week
One curated home or studio from the AECORD community, with story + photos.
